Jacobs has secured a sole-source engineering, procurement and development administration contract (EPMC) for power infrastructure firm Hut 8’s deliberate Beacon Level synthetic intelligence knowledge heart campus in Nueces County, Texas.
The award extends a partnership established earlier this 12 months after Jacobs was named EPCM lead for Hut 8’s River Bend campus in Louisiana and comes as contractors and grid operators adapt to escalating energy and interconnection calls for tied to hyperscale AI amenities.

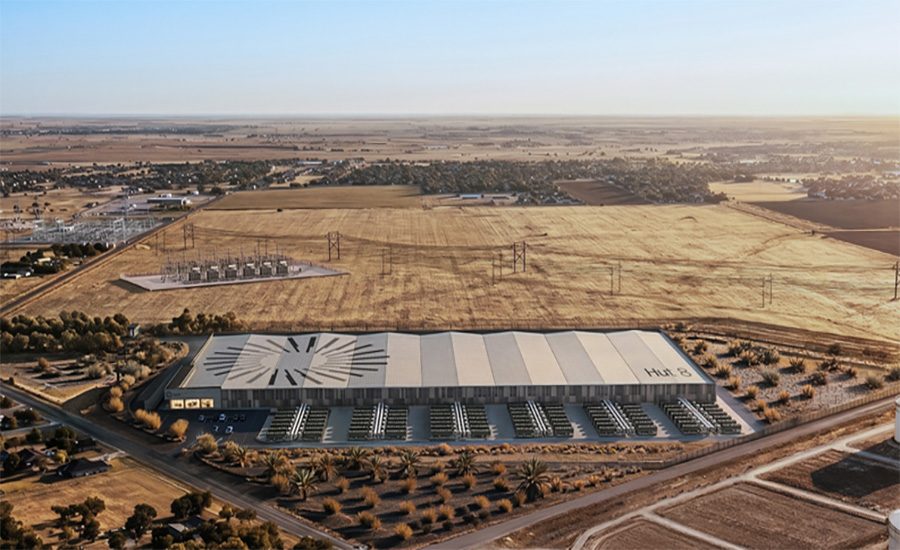

The multi-phase Beacon Level campus is designed to help as much as 1 GW of utility capability. Its preliminary 352-MW part is backed by a 15-year, triple-net lease valued at $9.8 billion over the bottom time period, together with a 3.0% annual escalator, based on Hut 8 disclosures.
The tenant, an unnamed “high-investment-grade firm” cited in investor supplies, will deploy devoted compute infrastructure on the web site to help AI coaching and inference workloads.
Hut 8 CEO Asher Genoot told Reuters the settlement is structured on a “take-or-pay, triple-net foundation with no termination for comfort.” Three renewal choices may push whole contract worth to roughly $25.1 billion, with anticipated common annual web working earnings of roughly $655 million upon stabilization.
Jacobs will oversee phased supply, built-in procurement and development administration, making use of design parts from the Louisiana challenge to the brand new campus and deploying a data center digital twin to simulate important belongings throughout commissioning. Preliminary energization is focused for 2027. The award comes as ERCOT advances proposed interconnection and reliability rule modifications tied to massive computational hundreds.
“This follow-on award underscores Hut 8’s confidence in Jacobs’ capacity to ship complicated AI infrastructure with pace, security and certainty,” Jacobs Chair and CEO Bob Pragada stated, asserting the award. “By combining our EPCM management with superior digital twin expertise, we’re setting the benchmark for AI infrastructure deployment, optimization and resiliency.”
Searching for fast solutions on development and engineering matters?
Strive Ask ENR, our new good AI search instrument.
Ask ENR →
The challenge additionally exhibits how quickly power-density assumptions are shifting throughout AI infrastructure design. Beacon Level was initially underwritten to serve Hut 8’s affiliated subsidiary, American Bitcoin Corp., as a part of a bitcoin mining technique, earlier than being repositioned to AI.

ERCOT knowledge present projected large-load interconnection requests accelerating sharply by way of 2030 as AI campuses and different high-density computational amenities reshape transmission planning and grid research.
Click on to enlarge
Chart courtesy of ERCOT
Following that shift, the primary knowledge corridor was initially scoped for 224 MW earlier than being redesigned to 352 MW after NVIDIA’s DSX reference structure superior towards materially greater rack-level energy densities.
Hut 8 stated the redesign elevated deliberate IT capability 57% with out increasing the challenge’s land or utility footprint. The campus is now engineered to that customary, with NVIDIA engaged as expertise accomplice alongside Jacobs, Vertiv and AEP Texas, a subsidiary of American Electrical Energy.
“Subsequent technology AI infrastructure shall be outlined by how shortly energy will be transformed into AI capability,” Vertiv CEO Giordano Albertazzi stated.
The primary part requires roughly 500 MW of utility capability. Hut 8 has executed an interconnection settlement with AEP Texas for the complete 1-GW campus and has already funded contribution-in-aid-of-construction necessities and commenced substation development. The Corpus Christi Regional Financial Improvement Corp. is listed as a challenge accomplice.
Hut 8 stated the challenge sits inside a broader 8,375-MW pipeline spanning tasks beneath development, growth, exclusivity and diligence. The corporate stated its whole contracted AI knowledge heart capability now stands at 597 MW with an mixture base-term contract worth of roughly $16.8 billion.
RELATED
Report: Billions of Dollars in Data Center Construction Risk Is Uninsured
ERCOT Reworks Giant-Load Interconnection Course of
The regulatory backdrop is evolving alongside a rising pipeline of hyperscale AI and computational infrastructure tasks.
On April 29, ERCOT’s technical advisory committee voted to recommend new frequency and voltage ride-through necessities for knowledge facilities and different high-density computational amenities—a class ERCOT now formally classifies as Giant Computational Masses.
ERCOT documented repeated situations of such amenities tripping offline throughout routine grid disturbances relationship again to October 2022 and stated greater than 200 GW of enormous hundreds are presently searching for interconnection to the Texas grid, a quantity the power supplier says has strained its present case-by-case examine course of.
After the April 29 vote, ERCOT filed a technical correction to revive an exemption cutoff date inadvertently omitted from the accredited draft, signaling the foundations stay in lively refinement forward of state regulatory submission.
A separate interconnection framework reform goals to interchange particular person challenge research with a system-wide batch examine course of. ERCOT has described the present strategy as having “proved inadequate” amid a surge in massive load requests, with every new software in a transmission zone able to invalidating prior research and increasing challenge timelines by years. The reform was tabled on Could 13 at ERCOT’s request, pending decision of remaining technical and coverage questions, with a Board vote focused for June 1 and an efficient date of July 10.
RELATED
Oracle’s $16B Michigan Data Center Secures Financing as Power Contracts Face Appeals
Beacon Level is Hut 8’s second AI campus, following River Bend in West Feliciana Parish, La. That challenge carries a 245-MW IT capability lease beneath a 15-year, $7-billion settlement, with preliminary commissioning focused for the primary quarter of 2027.
To finance River Bend’s development, Hut 8 closed a $3.25 billion providing of absolutely amortizing 16.5-year investment-grade senior secured notes—described by the corporate as the primary single-sponsor knowledge heart challenge to entry the investment-grade development bond market—on a non-recourse foundation.
Again in Nueces County, commissioners met May 13—the identical day ERCOT tabled its interconnection overhaul—to debate a proposed Beacon Level Knowledge Middle Reinvestment Zone, coming into closed session to discuss with attorneys on the authorized and financial growth dimensions of a possible settlement.
ENR reached out to ERCOT and Jacobs for extra data, however didn’t obtain an instantaneous response.
Trending Merchandise
CRAFTSMAN Pliers, 8 & 10″, 2Piece Groove Joint Set (CMHT82547)
TT TRSMIMA Safety Harness Fall Protection Upgrade 4 Quick Buckles Construction Full Body Harness 6 Adjustment D-ring
BIC Wite-Out Brand EZ Correct Correction Tape, 19.8 Feet, 4-Count Pack of White Correction Tape, Fast, Clean and Easy to Use Tear-Resistant Tape Office or School Supplies
